A24 Blankenburg verbinding
Rotterdam

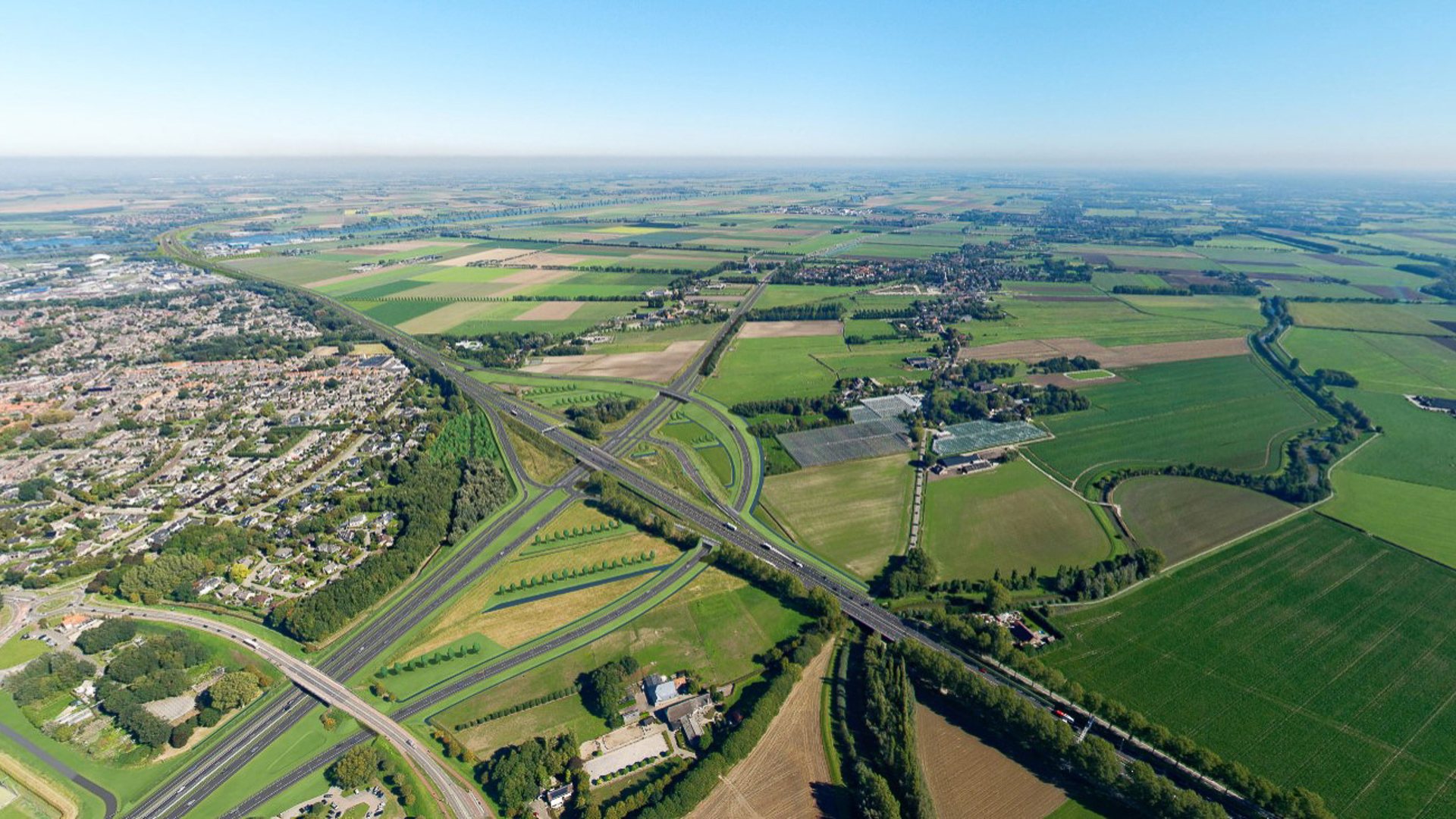

Improving 40 kilometres of motorway between Everdingen and Hooipolder
Third place in the traffic jam top 10: that will soon be a thing of the past for A27 Houten-Hooipolder. Rijkswaterstaat is tackling this bottleneck by, among other things, improving 40 kilometres of motorway between Everdingen and Hooipolder. This huge project has been awarded to Ballast Nedam and Fluor Infrastructure. Joining forces under the name 'ALSÉÉN'.
We are improving a total of 40 kilometers of highway. In the direction of Utrecht, the A27 between the Hooipolder and Everdingen junctions will have three lanes. Between Werkendam and Scheiwijk, these will be regular lanes, and the rest of the route will have a rush-hour lane. In the other direction, there will be four regular lanes between Scheiwijk and Werkendam. The other parts of the route will have three lanes, one of which will be a rush-hour lane.

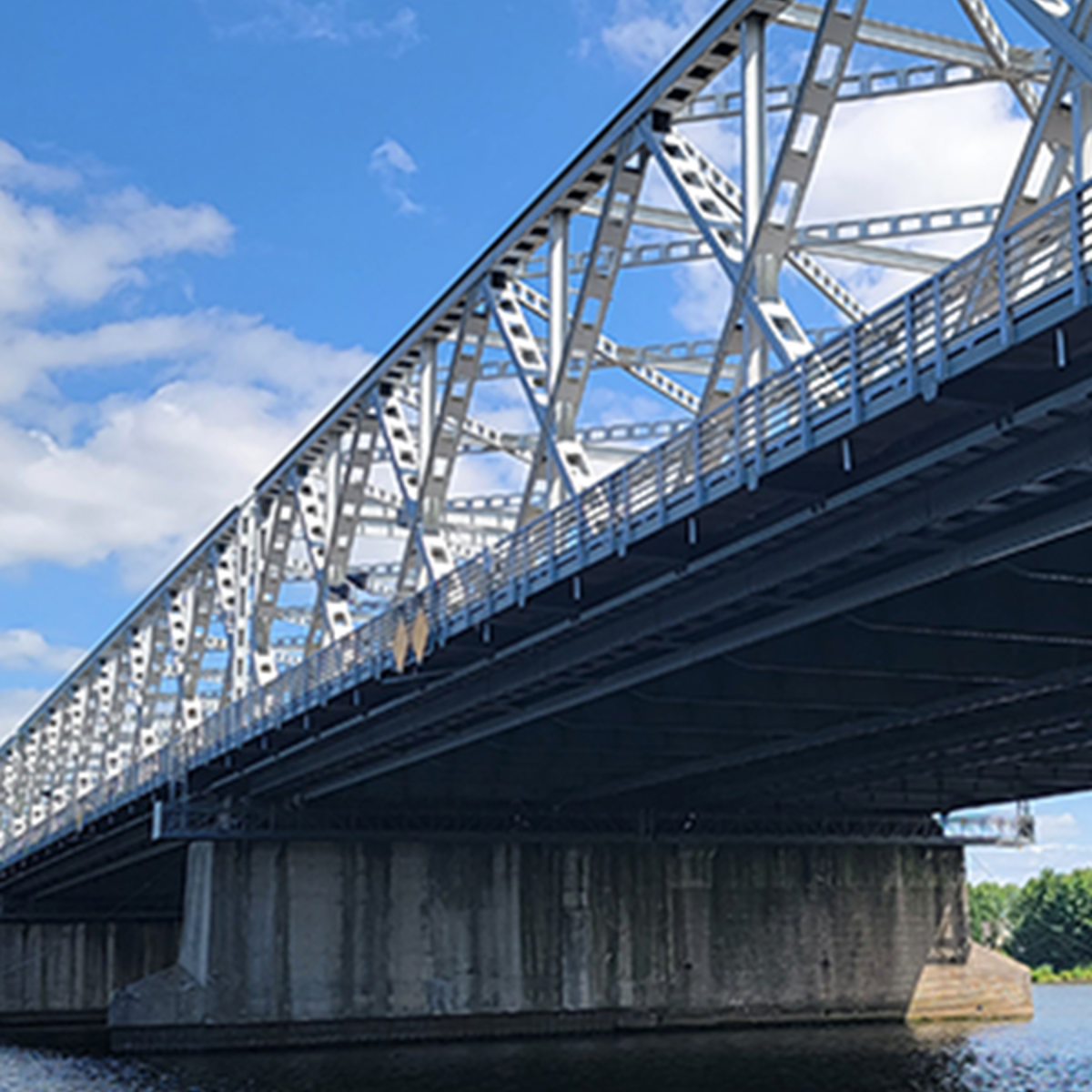

This means that we will also be replacing or widening 50 existing structures, such as the Merwede Bridge near Gorinchem, on this route. To minimize disruption to road users, we will be building the new bridge in stages.
First, we will build a new bridge next to the existing bridge, which all traffic can use. We will then demolish the old bridge and build a second new bridge in its place. Ultimately, there will be two bridges side by side at both locations: one for northbound traffic and one for southbound traffic.
A special component is the renewal of the asphalt on the existing steel Merwede Bridge. Due to the movements of the bridge, an innovative structure was chosen, consisting of mastic asphalt, roofing felt, and a special top layer. Ballast Nedam belongs to a select group in the Netherlands that has mastered this technique.
The renovation of the A27 motorway is an important part of the major renovation and refurbishment project in the Netherlands. Many bridges and viaducts in the Netherlands are around 60 to 70 years old and will need to be renovated and/or replaced in the coming years.
An important aspect of keeping the risks manageable within the project is Rijkswaterstaat's two-phase approach for, among other things, the Merwede Bridge and the area with poor soil conditions between Gorinchem and Lexmond. In the first phase, we will work with Rijkswaterstaat to develop the design, planning, and cost estimate. In the second phase, we will carry out this work. This two-phase contract allows us to base the costs more accurately on the current situation and distribute the potential risks more fairly. The implementation agreement for road section 7 (Lexmond–Gorinchem) was signed in December 2025. This officially marks the start of the implementation phase for this section, an important step towards the full realization of the Everdingen–Gorinchem corridor.
Our own environmental team regularly consults with all parties involved, such as municipalities, businesses, and residents in the region. In addition, the impact on the environment and nature has been considered since the tendering process. For example, we will work with emission-free equipment as much as possible, construct 3.5 kilometers of nature-friendly banks, install 630 insect hotels, and sow a flower-rich grass mixture on the verges. We will also install 260 traffic signs made from recycled aluminum, 615 traffic signs made from sustainable rice husk fiber, 2,079 reflector posts made from recycled PVC, and 831 bottle posts made from bamboo.
In addition, we are conducting advanced geotechnical analyses to accurately map the soil conditions. This includes BIM-driven settlement predictions and full-scale test pits. In this way, we are ensuring a stable and safe infrastructure, even on the soft peat and clay soils in the area.
A recent milestone was the insertion of a new underpass beneath the A27 motorway at the Hooipolder junction in just 100 hours. This spectacular operation could be followed live via a livestream provided by the project team. In addition, the underpass at Oosterhoutseweg has also been successfully slid into its final position — an important step in the realization of the junction's new connecting curve.
To successfully carry out this project, we are working together with Fluor Infrastructure under the name ALSÉÉN. We have previously worked together successfully on the A9 Gaasperdammerweg project.
The research and design phases of the two-phase components have now been completed and we are currently in the implementation phase. We have also already started construction of the connection to the future Groote Haar business park in Gorinchem and improvements to the Hooipolder junction. The implementation agreement for road section 7 (Lexmond–Gorinchem) was signed in December 2025. This marks the official start of the implementation phase for this section, an important step towards the full realization of the Everdingen–Gorinchem corridor.
Managing Director Ballast Nedam Infra Projects a.i.
